Project Background

Council is planning a new shared walking and cycling path connecting Mascot to Eastlakes. The project aims to create a more connected, accessible, and well-serviced transport network for the community.

The new shared path and cycleway will make Mascot safer and more convenient for people of all ages and abilities to walk and ride, supporting everyday short trips and encouraging more active travel.

The proposed route aims to improve:

  • Safety: Reduce risks for cyclists, pedestrians, and school students through targeted safety upgrades.
  • Accessibility and inclusion: Support people of all ages and abilities by providing safer, easier, and more comfortable travel options.
  • Connectivity: Improve links across Mascot, Eastlakes, and neighbouring precincts, connecting with existing and planned active transport networks.

To deliver these improvements, some changes may be required, including adjustments to on-street parking, the relocation of bus stops, and changes to school kiss-and-ride arrangements near schools.


Have Your Say - We want to hear from you. Your local knowledge is vital to shaping this project.

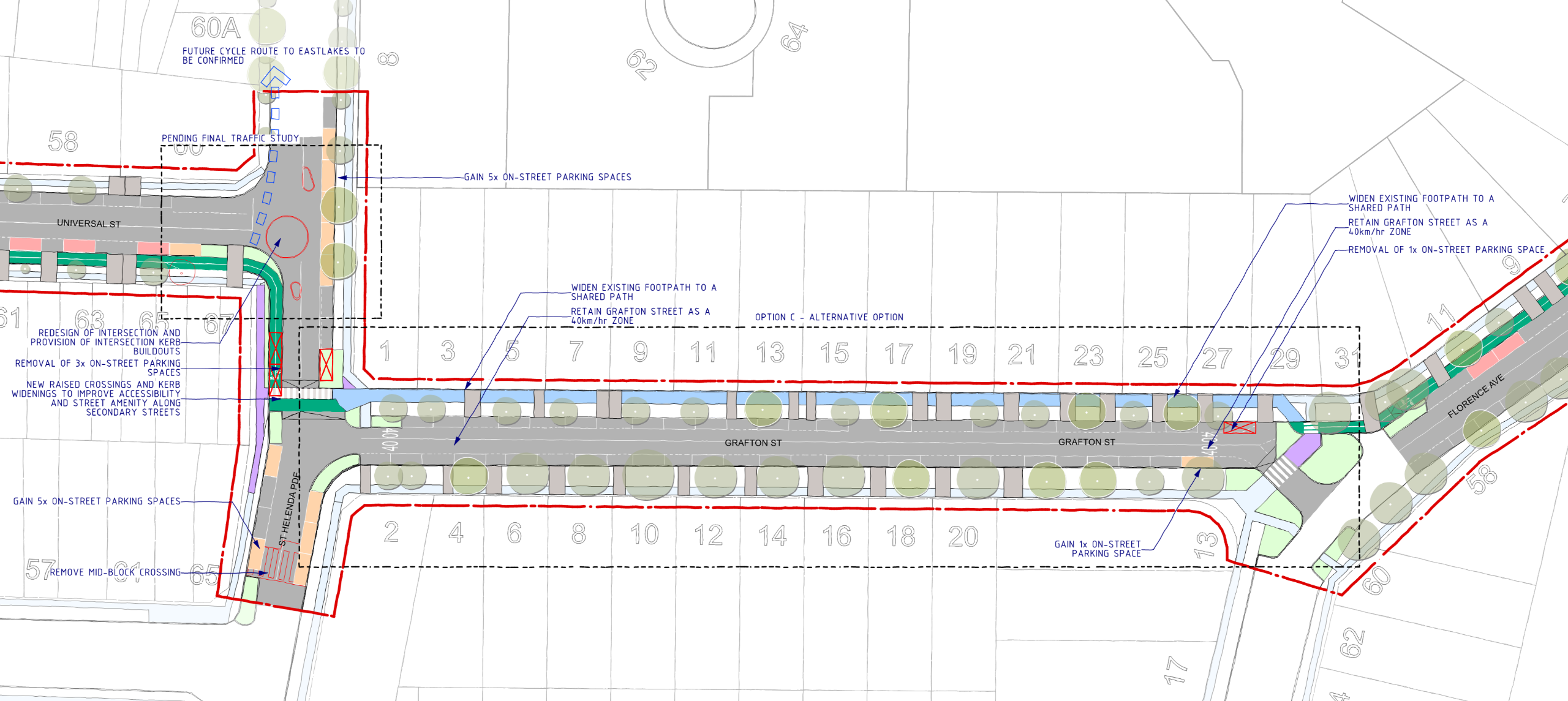

Grafton Street Option A

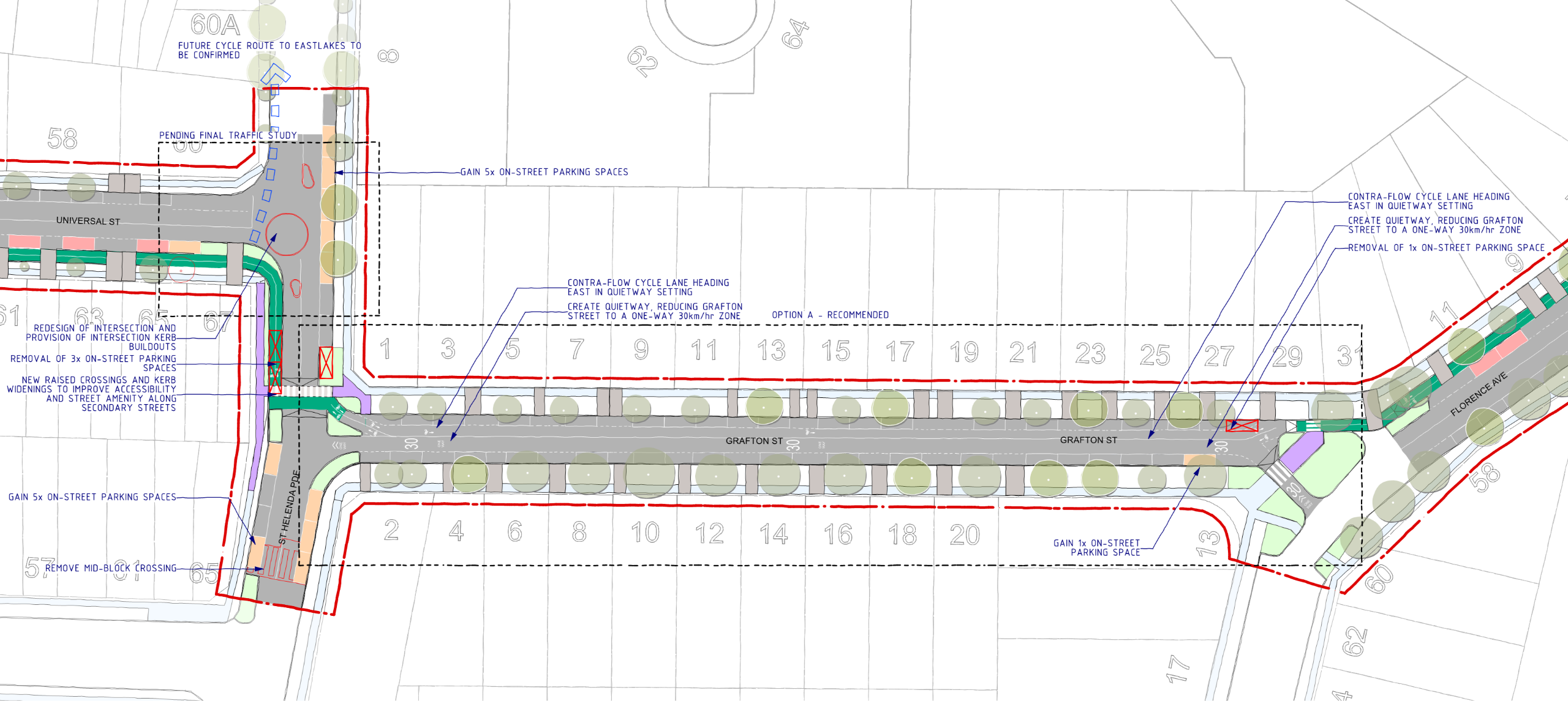

Grafton Street Option B

Grafton Street Option C


Have Your Say

Project Lifecycle

  • Timeline item 1 - complete

    30 June 2025 - City of Sydney publishes the 'Sydney Cycling Map'

    Bayside Council consults the Sydney Cycle Map to inform potential Active Transport Corridor options for further investigation in the Feasibility Study.

  • Timeline item 2 - complete

    Council conducts informal preliminary discussions with JJ Cahill High School and Eastlakes Public School

  • Timeline item 3 - complete

    Council contacts transport providers

    Council undertakes informal discussions with bus service providers operating along Maloney Street, George Street, and St Helena Parade. To identify major bus routes and bus zones.

  • Timeline item 4 - complete

    Council contacts TfNSW and freight management teams

    Informal preliminary discussions with transport operators regarding active transport planning, freight, road safety, and traffic management in the precinct.

  • Timeline item 5 - complete

    September 2025 - Council conducts a Feasibility Study on Coward Street

  • Timeline item 6 - complete

    Friday, 20 February 2026 - Feedback Opens

  • Timeline item 7 - complete

    February 2026 - Council notifies local businesses of the community consultation for the proposed Active Transport Corridor

    Council has distributed a letter to local residents to inform them of the community consultation.

  • Timeline item 8 - active

    Friday, 27 February 2026 - On-site public engagement

    Come to Council's Lunar New Year Festival to view the plans and chat to our engagement team.

  • Timeline item 9 - incomplete

    Monday, 23 March 2026 - Feedback Closes

    Post exhibition, a report on the results will be considered by Council with recommendation on any design changes to finalise the feasibility and concept design report.

  • Timeline item 10 - incomplete

    Under review

    Contributions to this consultation are closed for evaluation and review.

  • Timeline item 11 - incomplete

    Final decision or outcome

    Council applies for grants to continue with detailed design documentation in financial year 26/27. Council will determine an implementation plan as part of the detailed design phase.

    Select the +Follow key at the top of the project page to be notified when this project is updated.

  • Timeline item 12 - incomplete

    2028 - Construction is anticipated to commence

FAQs

Will any speed limits change?

Council is not authorised to set or change speed limits. Speed limits are managed by Transport for NSW (TfNSW). While the proposed design changes may support lower vehicle speeds, any decision to amend speed limits would be made by TfNSW.


Will this project increase parking?

Based on the concept plan prepared, Council anticipates a reallocation of parking spaces leading to a net gain of 17 parking spaces.


Will there be impacts to existing parking?

Some options do require partial parking removal to ensure safe widths for cycleways. These losses are minimised where possible and clearly quantified in the engagement materials. Residential streets are prioritised for parking retention, with trade-offs discussed transparently.

Parking losses have been minimised. The project will result in a nett gain of 11 spaces.

MASCOT TO EASTLAKES CYCLEWAY ON-STREET PARKING

Existing

Change

Total

O'Riordan Street

0

0

0

Coward Street

224

- 5

219

Maloney Street

1

0

1

Universal Street

61

+ 1

62

St Helena Parade

8

+ 10

18

Grafton Street

31

0

31

Florence Street

53

+ 5

58

TOTAL

378

+ 11

389

Extracted from page 4 of the feasibility report, the recommended route passes near several key education facilities, including:

  • Eastlakes Public School
  • JJ Cahill Memorial High School
  • Mascot Child Care Centre

In the broader study area, the investigation also considered additional schools and early learning centres, including:

  • Mascot Public School
  • St Therese Catholic Primary School
  • Several smaller pre-schools and childcare centres

This ensures the project considers the needs of children and families when planning safe and accessible active transport routes.

  • The feasibility study has considered potential impacts to businesses, particularly along Coward Street's mixed residential-commercial zones. The recommended route seeks to avoid negative impacts to businesses.
  • During construction, there may be temporary access disruptions, which will be managed through careful staging and communication with affected tenants and property owners.
  • Long-term benefits of improved active transport infrastructure include:
    • Increased foot and cycle traffic, particularly from commuters and locals
    • Safer and more attractive streetscapes that encourage visitation and patronage
    • Potential for improved retail vibrancy and visibility
    • Car parking loss will be transparently presented and minimised where possible. Engagement materials will clearly explain any changes to access and amenity.

Following this public consultation, Council will review the outcomes and any recommended design changes to finalise the feasibility and concept design.

Detailed design is not currently funded and will be subject to community support, Council endorsement, and grant funding. Council intends to seek funding to undertake detailed design as early as 2026 (FY 2026/27), with an implementation plan developed during this phase.

Subject to funding, approvals, and coordination requirements (including TfNSW), construction is anticipated to commence in 2028.

Shared paths

Shared paths are for both bicycle riders and pedestrians. Bicycle riders must keep left where practical, give way to pedestrians (including slowing or stopping if needed), and stay left of oncoming riders. Riders of skateboards, foot scooters, and rollerblades must also keep left where practical and give way to all other pedestrians.


Bicycle paths/Cycleways

Bicycle paths are different from bicycle lanes, and riders don’t have to use them. They begin with a ‘Bicycle path’ sign or road marking and can run alongside roads or through off-road areas. These paths can also be used by people on skateboards, foot scooters, rollerblades, wheelchairs, mobility scooters, and by postal workers on motorcycles. Other vehicles may only enter a bicycle path when accessing a road or where signed, and must give way to all users on the path.

A feasibility study is an early-stage investigation that explores whether a project is practical, safe, and worthwhile. For cycleway projects, this includes:

  • Reviewing existing road conditions, footpaths, and traffic volumes
  • Identifying different route options and types of cycling infrastructure
  • Considering impacts to things like trees, parking, driveways, and bus stops
  • Reviewing how a project might connect to other transport and cycling networks
  • Understanding the challenges and opportunities of delivering the project
  • The study does not involve final designs. It helps Council decide whether the project is worth progressing to detailed design and funding stages.

(Read the Feasibility Study for this project)

Council has prioritised tree retention across all options. In locations where shared paths are proposed, impacts on trees are to be minimised through careful material selection to avoid root damage and canopy loss. Separated cycleway elements are unlikely to result in tree loss. Any unavoidable impacts will be clearly communicated.

TfNSW will determine this once their ongoing studies are complete.

TfNSW is undertaking their own feasibility studies west of Bourke Street for a cycleway which connect to Alexandra Canal. While Council is working closely with TfNSW to ensure the two feasibility reports align, both projects are working to separate time constraints.

Shared paths are designed to operate at lower speeds with high visibility. In constrained environments, they can be a practical solution. Council will apply best-practice signage, line marking and landscape buffers to reduce conflict and promote courteous use. We typically avoid shared path arrangements in areas where pedestrian traffic is high, such as in the vicinity of Mascot Train Station.
